PROJECTS OF INTEREST
- HWY 24 WASTEWATER UTILITY CORRIDOR IMPROVEMENTS
- SOUTHEAST SERVICE AREA WASTEWATER CAPACITY IMPROVEMENTS
- SUMMERHOUSE WWTP INTERIM CAPACITY IMPROVEMENTS - PHASES I & II
- BURNS STREET SEWER LINE REPLACEMENT

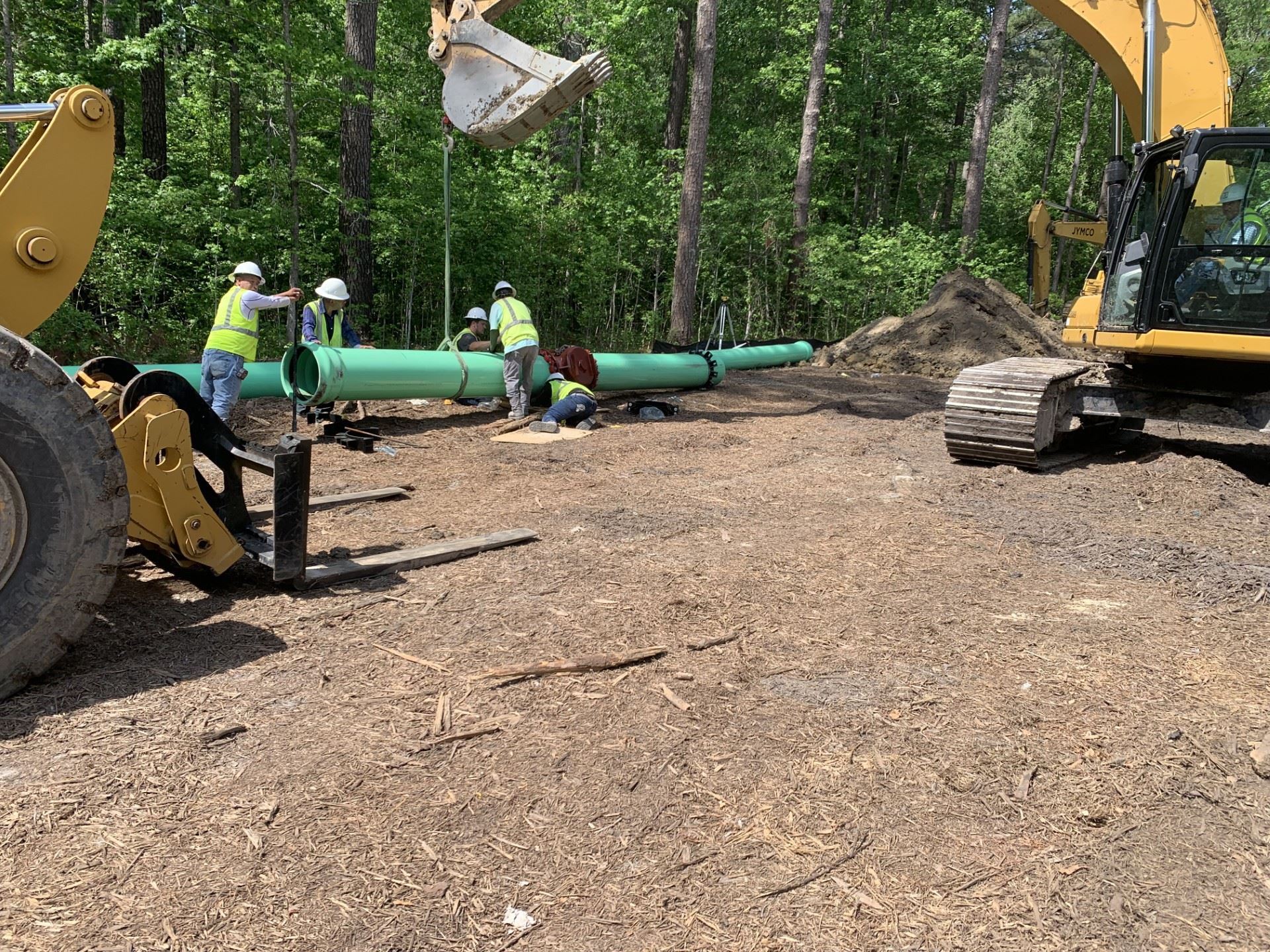

HIGHWAY 24 WASTEWATER UTILITY CORRIDOR IMPROVEMENTS
BRIEF EXPLANATION OF PROJECT AND GOALS
The Highway 24 Wastewater Utility Corridor Improvements Project consists of the completion of design, permitting, and construction of a new 18" diameter sewer force main and associated pump stations to connect the Swansboro collection system to an existing ONWASA pump station located at the intersection of Piney Green Road and Highway 24. The total estimated length of the 16" and 18" diameter force main is approximately 36,000 linear feet with the addition of two new pump stations and the rehabilitation and expansion of two existing pump stations. The project will provide the additional wastewater treatment capacity necessary to address anticipated growth in the Northeast and Highway 24 Corridor area by sending flow to the Marine Corps Base Camp Lejeune for treatment under an existing agreement with ONWASA. The Swansboro Wastewater Treatment Plant will be taken out of service and flow will be conveyed to a new Swansboro Pump Station and continue to the renovated and expanded pump station at the intersection of Piney Green Road and Highway 24.
WHO IS PERFORMING THE WORK?
The Wooten Company is the project's design engineer. T.A. Loving Company is performing the construction of the pump stations and JYMCO Construction Company, Inc. is performing the construction of the force main.

WHY IS ONWASA INSTALLING A FORCE MAIN AND PUMP STATION ALONG HIGHWAY 24?
ONWASA is constructing the force main and pump stations along Highway 24 to accommodate the current demand for capacity, as well as the anticipated growth in the Northeast Service Area.
WHERE IS THE PROJECT LOCATED?
The force main begins at the intersection of Piney Green Road and Highway 24 and along Highway 24 ending at Hubert Blvd where it interconnects with an existing 12" force main. The two new pump stations are located at the Hubert Water Treatment Facility and the Swansboro Wastewater Treatment Plant. The two pump station renovations are located at the Piney Green Pump Station and Halls Creek Pump Station.
HOW MUCH WILL THE PROJECT COST AND HOW WILL IT BE FUNDED?
Total construct costs are approximately $27.7M for both the force main and pump station contracts. ONWASA awarded contracts to companies, T.A. Loving Company and JYMCO on June 20, 2024. The Highway 24 Wastewater Utility Corridor Improvements Project is funded by the sale of bonds with approval from the Local Government Commission (LGC).
WHAT IS THE PROJECT TIMELINE?
The Wooten Company began final design in January 2021 on the force main and pump stations. Construction began on December 16, 2024, and is anticipated to be completed in the fall of 2026.
HOW DOES THIS HELP THE RESIDENTS IN THE ONWASA SERVICE AREA?
The project is increasing the capacity for the residents and future development of Onslow County in the Northeast Service Area of the ONWASA wastewater system.

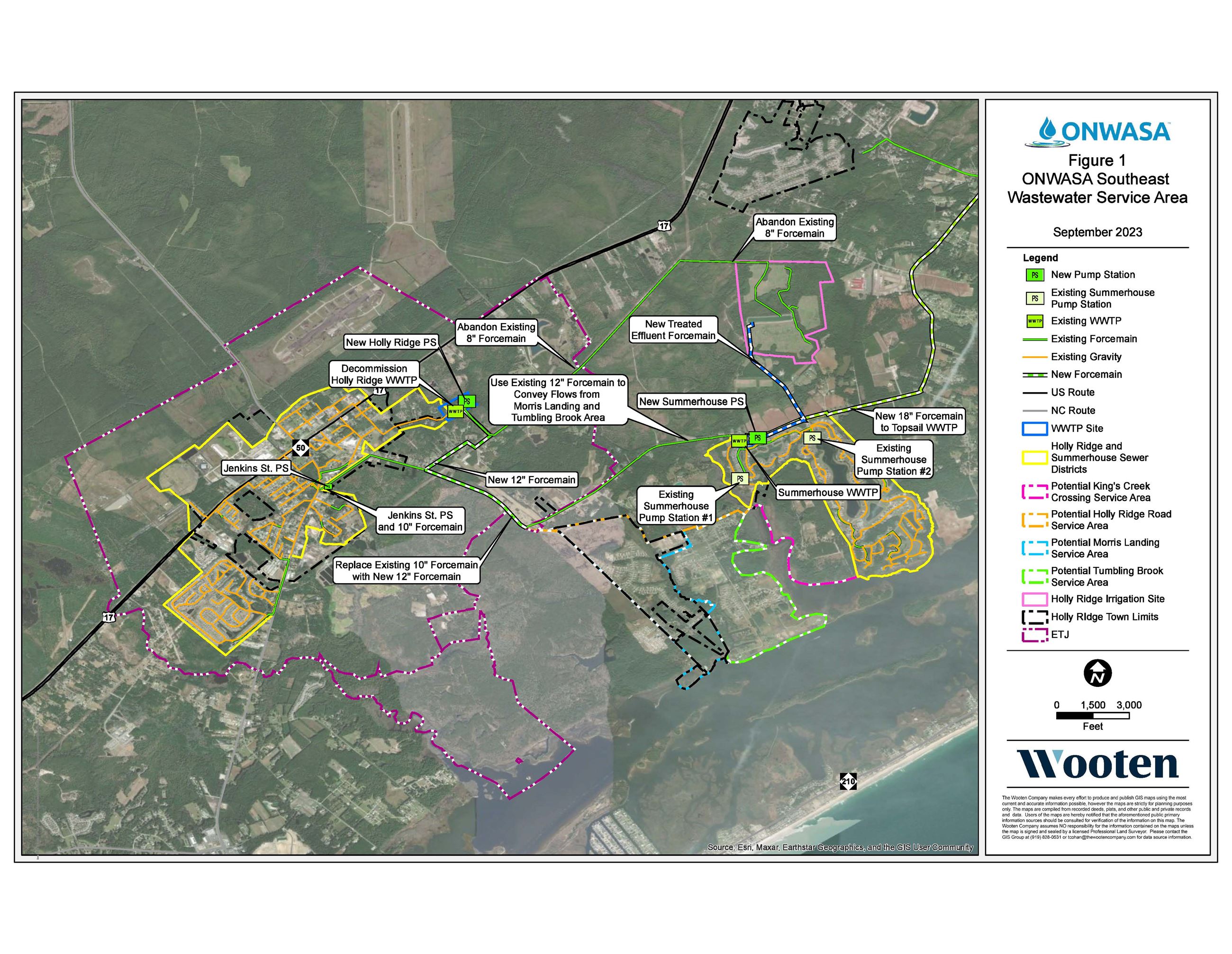

SOUTHEAST SERVICE AREA WASTEWATER CAPACITY IMPROVEMENTS
BRIEF EXPLANATION OF PROJECT AND GOALS
The Southeast Service Area Wastewater Capacity Improvements Project consists of the completion of design, permitting, and construction of a proposed 12" and 18" diameter sewer force main and two proposed pump stations to connect the Southeast Area of ONWASA's service area and convey wastewater to the Southeast Regional WWTF.
WHERE IS THE PROJECT LOCATED?
The 12" force main begins at the proposed Holly Ridge Pump Station and extends to the proposed Summerhouse Pump Station. The proposed 18" force main continues from the proposed Summerhouse Pump Station to end at the Southeast Regional WWTF. The proposed treated effluent force main begins at the Summerhouse Pump Station and ends at the Holly Ridge Spray Field.
WHO IS PERFORMING THE WORK?
The Wooten Company is the project's design engineer. T.A. Loving Company is performing the construction on the pump stations and C.M. Mitchell Construction, Inc. is performing the construction of the force main.
HOW MUCH WILL THE PROJECT COST?
Total construction costs are approximately $17.2M for both the force main and pump station contracts. ONWASA received a $10 million grant from the State of North Carolina to help pay some of the project cost. ONWASA awarded contracts to companies, C.M. Mitchell Construction and T.A. Loving Company on March 20, 2025.
WHAT IS THE PROJECT TIMELINE?
The Wooten Company began final design in 2024 on the force main and pump stations. Construction is anticipated to begin in the Summer of 2025 and is forecasted to be completed by the end of 2027.
HOW DOES THIS HELP THE RESIDENTS IN THE ONWASA SERVICE AREA?
The project is increasing the capacity for residents and future development in Onslow County within the Southeast Service Area of the ONWASA wastewater system.

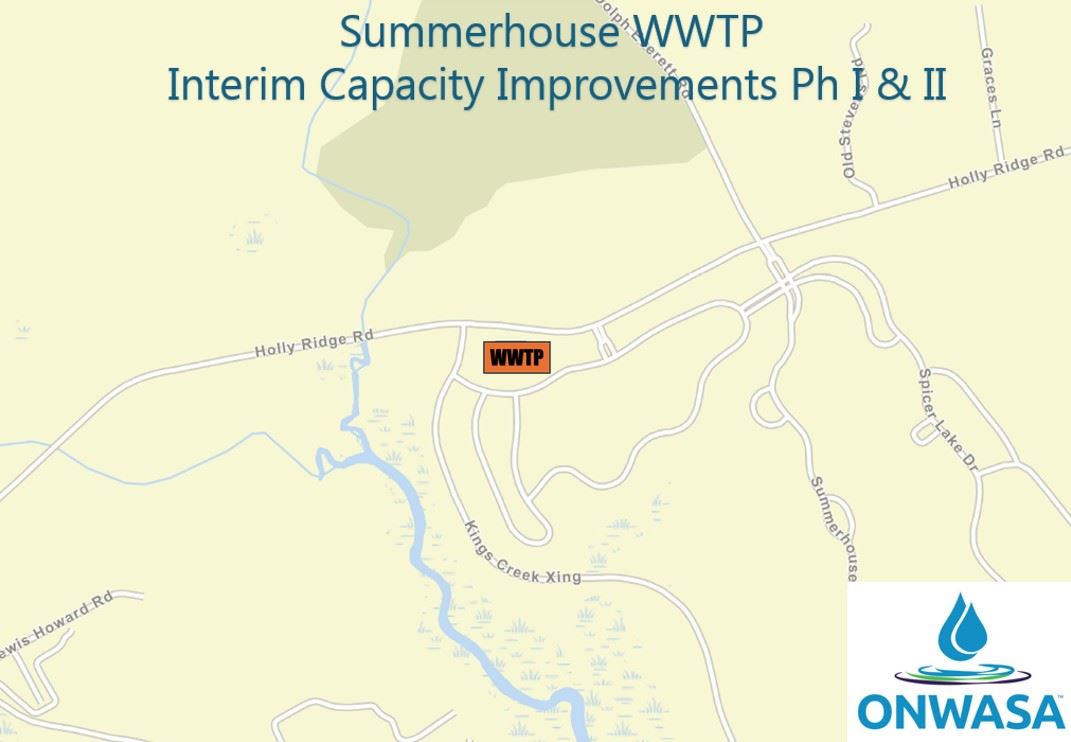

SUMMERHOUSE WWTP INTERIM CAPACITY IMPROVEMENTS PHASES I & II
BRIEF EXPLANATION OF PROJECT AND GOALS
The Summerhouse WWTP Interim Capacity Improvements Project, completed in two phases focuses on upgrading and expanding the plant to ensure it can treat its full permitted capacity while enhancing the overall quality and reliability of the treatment process.
WHERE IS THE PROJECT LOCATED:
The Summerhouse Wastewater Treatment Plant is located at 351 Holly Ridge Road in Onslow County.
WHO IS PERFORMING THE WORK?
- Design Engineer: McKim & Creed
- Phase I Construction: ELJ, Inc. (Expected completion: Fall 2025)
- Phase II: Currently in design and expected to be advertised for bidding by Fall 2025.
WHY IS ONWASA IMPROVING THE SUMMERHOUSE WWTP?
The Southeast Wastewater Service Area is experiencing significant growth. These improvements will expand the plant's capacity and prepare the system to meet both current needs and future development in the area all while enhancing the overall quality and reliability of the treatment process.
HOW MUCH WILL THE PROJECT COST?
Total construction costs for Phase I are approximately $3M. ONWASA awarded the construction contract to ELJ, Inc. in August 2024. Cost estimates for Phase II will be available after bidding in the Fall of 2025.
WHAT IS THE PROJECT TIMELINE?
Construction of Phase I began in August 2024 and is expected to be completed in the Fall of 2025. Construction for Phase II is anticipated to begin in late 2025, with an estimated completion in Fall of 2026. Additional details for the timeline of Phase II will be made available following the award of the construction contract.
HOW DOES THIS HELP THE RESIDENTS IN THE ONWASA SERVICE AREA?
The project is increasing the capacity and treatment quality for residents and future development in Onslow County within the Southeast Service Area of the ONWASA Wastewater System.

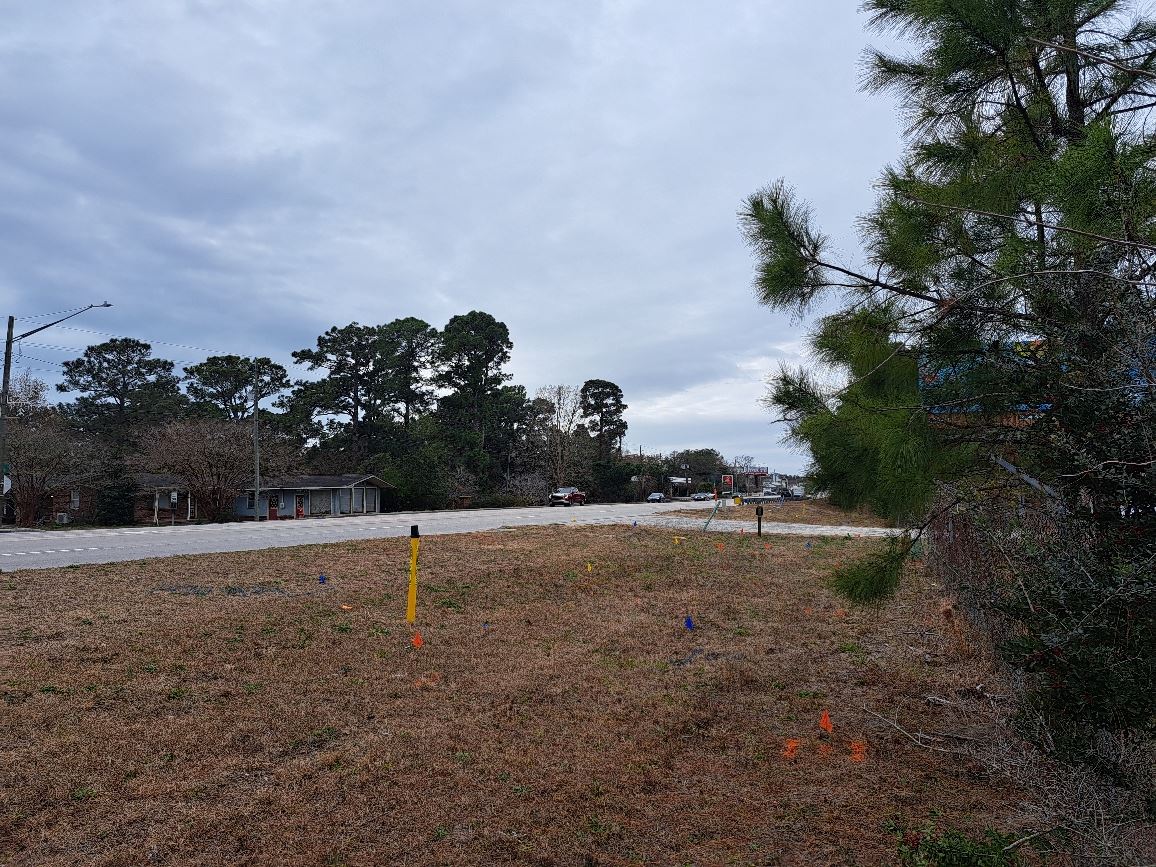

BURNS STREET SEWER LINE REPLACEMENT
BRIEF EXPLANATION OF PROJECT AND GOALS
Work includes the construction of approximately 125 linear feet of 8-inch gravity sewer, 16-inch steel encasement by dry bore and jack, two sewer manholes, and abandonment in place of approximately 100 linear feet of existing failing 8-inch gravity sewer line that runs under US Highway 17.
WHO IS PERFORMING THE WORK?
TA Loving is the contractor for this NCDOT approved project.
WHERE IS THE PROJECT LOCATED?
The location of the project is at the intersection of US Highway 17 and Burns Street in Holly Ridge.
HOW MUCH WILL THE PROJECT COST?
The total cost of this project is $517,100.
WHAT IS THE PROJECT TIMELINE?
Work is expected to begin in mid-February 2026, with estimated completion is May 2026.
